ICRA: Recent changes to Hybrid annuity model aids in improved cash conversion cycle and protects the returns of HAM developers

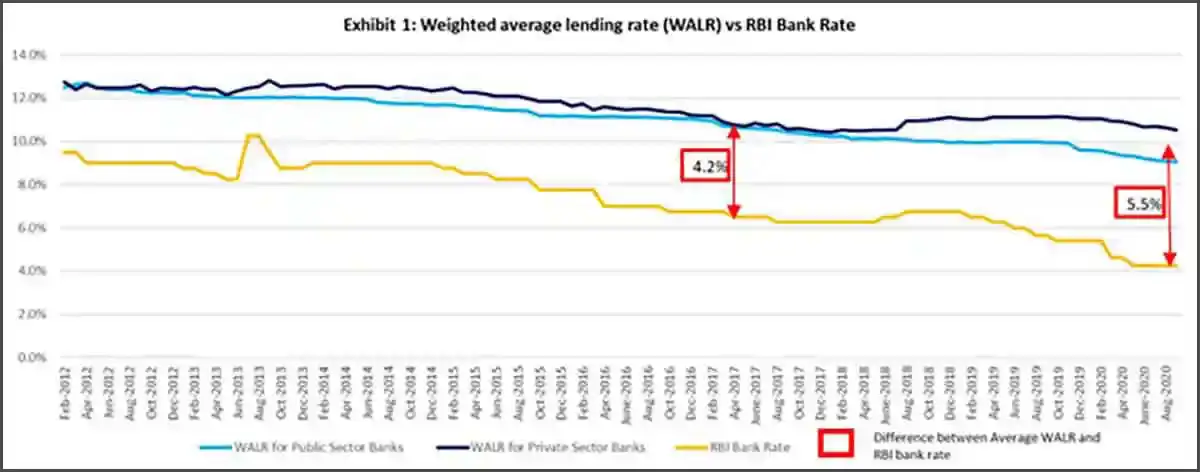

Elaborating further, Rajeshwar Burla, Vice President, Corporate Ratings, ICRA says, “Linking interest on annuities with RBI’s bank rate has been a pain point for developers due to inefficient transmission of interest rates. With the average MCLR replacing the bank rate, there will be a natural hedge between the annuity inflows and interest costs thereby reducing the interest rate risks to a large extent. This is a positive move that will protect the returns of the HAM developers and improve the overall attractiveness of the model.”

The other major revision is the grant payment from the authority which will now be paid in 10 installments instead of five earlier, thus the spacing between the payment milestones is reduced. Every 10% physical progress is eligible for 4% release of grant (earlier 8% of grant was released for every 20% progress, refer Exhibit 2), this will aid in improvement of the cash conversion cycle for the contractors executing the HAM projects as their payments are back to back in nature.
“While these changes will be applicable for future awards, the fate of the existing HAM projects is hanging in balance. Change in applicable interest rate on annuities is critical even for existing projects. This will not only improve the coverage metrics for these projects and consequently aid in refinancing but also helps the developers to unlock the capital by selling these assets and redeploy the capital in new BOT projects which is the need of the hour,” Burla added.
| Exhibit 2: Summary of key changes made to the model concession agreement for Hybrid Annuity Model | ||
| Clause | Revised | Earlier |
| Payment during construction | 10 instalments of 4% each amounting to 40% of BPC (adjusted for price index multiple) 1) First payment milestone - on achievement of 5% physical progress 2) Second payment milestone - on achievement of 10% physical progress 3) Third payment milestone - on achievement of 20% physical progress 4) Fourth payment milestone - on achievement of 30% physical progress 5) Fifth payment milestone - on achievement of 40% physical progress 6) Sixth payment milestone - on achievement of 50% physical progress 7) Seventh payment milestone - on achievement of 60% physical progress 8) Eighth payment milestone - on achievement of 70% physical progress 9) Ninth payment milestone - on achievement of 80% physical progress 10) Tenth payment milestone - on achievement of 90% physical progress |
5 instalments of 8% each amounting to 40% of BPC (adjusted for price index multiple) 1) First payment milestone - on achievement of 10% physical progress 2) Second payment milestone - on achievement of 30% physical progress 3) Third payment milestone - on achievement of 50% physical progress 4) Fourth payment milestone - on achievement of 75% physical progress 5) Fifth payment milestone - on achievement of 90% physical progress |
| Interest on annuities | Interest shall be due and payable on the reducing balance of Completion Cost at an interest rate equal to the average MCLR of top 5 scheduled commercial banks plus 1.25% Authority shall declare the list of top 5 scheduled commercial banks on 1st September every year based on the balance sheet size declared in their annual reports. The 1-year MCLR of these banks shall be taken at the start of every quarter. |
Interest shall be due and payable on the reducing balance of Completion Cost at an interest rate equal to the applicable Bank Rate plus 3% |
